Contents



                        Abbreviations

                        Executive Summary

1                      Introduction

1.1                   Background

1.2                   Scope of the EM&A Report

1.3                   Organization Structure

1.4                   Summary of Construction Works

1.5                   Summary of EM&A Programme Requirements

1.6                   Status of Statutory Environmental Compliance with the Environmental Permit

1.7                   Status of Other Statutory Environmental Requirements

2                      EM&A Results for Tung Chung East

2.1                   Air Quality

2.2                   Noise Monitoring

2.3                   Water Quality Monitoring

2.4                   Soft Shore Ecological Monitoring

2.5                   EM&A Site Inspection

2.6                   Waste Management Status

2.7                   Implementation Status of Environmental Mitigation Measures

2.8                   Summary of Exceedances of the Environmental Quality Performance Limit

2.9                   Summary of Complaints, Notification of Summons and Successful Prosecutions

3                      Future Key Issues

3.1                   Construction Programme for the Coming Month

3.2                   Monitoring Schedule for the Coming Month

4                      Conclusion and Recommendation






Annexes

Annex A   Project Organisation

Annex B   Environmental Mitigation Implementation Schedule

Annex C   Status of Submissions and Implementation Status of Mitigation Measures under EP

Annex D   Status of Statutory Environmental Requirements

Annex E   Air Quality
Annex E1 Calibration Certificates
Annex E2 Monitoring Schedule
Annex E3 Monitoring Results
Annex E4 Event and Action Plan

Annex F   Noise
Annex F1 Calibration Certificates
Annex F2 Monitoring Schedule
Annex F3 Monitoring Results
Annex F4 Event and Action Plan

Annex G  Water Quality
Annex G1 Calibration Certificates
Annex G2 Monitoring Schedule
Annex G3 Monitoring Results
Annex G4 Event and Action Plan

Annex H   Soft Shore Ecology
Annex H1 Monitoring Schedule
Annex H2 Monitoring Results
Annex H3 Event and Action Plan

Annex I    Cumulative Statistics on Exceedances, Environmental Complaints, Notification of Summons and Status of Prosecutions

Annex J   Monitoring Schedule for the Next Reporting Period





Abbreviations

C&D

Construction and Demolition

CAP

Contamination Assessment Plan

CEDD

Civil Engineering and Development Department

CWD

Chinese White Dolphin

DCM

Deep Cement Mixing

DO

Dissolved Oxygen

EIA

Environmental Impact Assessment

EIAO

Environmental Impact Assessment Ordinance

EIS

Ecologically Important Stream

EM&A

Environmental Monitoring and Audit

EP

Environmental Permit

EPD

Environmental Protection Department

ER

Engineer's Representative

ERM

ERM-Hong Kong, Limited

ET

Environmental Team

HVS

High Volume Sampler

IEC

Independent Environmental Checker

PDA

Planned Development Area

PME

Powered Mechanical Equipment

QPME

Quality Powered Mechanical Equipment

RAP

Remediation Action Plan

RR

Remediation Report

RTTM

Real Time Tracking and Monitoring

SS

Suspended Solid

TCB

Tung Chung Bay

TCE

Tung Chung East

TCNTE

Tung Chung New Town Extension

TCW

Tung Chung West

The Project

Tung Chung New Town Extension (East)

THW

Tai Ho Wan

TSP

Total Suspended Particulate

Updated EM&A Manual

Updated Environmental Monitoring and Audit Manual for Tung Chung New Town Extension prepared by ERM under Agreement No. CE 60/2017 (EP) and deposited to EPD under Environmental Permit No. EP-519/2016




Executive Summary

Tung Chung New Town Extension (TCNTE) is one of the major initiatives under the Government's multi-pronged approach to increase land supply to meet Hong Kong's medium- to long-term needs for housing, economic and social developments.  The Environmental Impact Assessment (EIA) Report for TCNTE (Register No. AEIAR-196/2016) was approved on 8 April 2016 and the Environmental Permit (EP) No. EP-519/2016, covering the construction and operation of TCNTE, was granted on 9 August 2016. The EIA Report and EP cover both Tung Chung East (TCE) and Tung Chung West (TCW).  ERM-Hong Kong, Limited (ERM) is commissioned to undertake the role of Environmental Team (ET) for the construction and operation of TCE Project (“the Project”) in accordance with the requirements specified in the EP, Updated Environmental Monitoring and Audit (EM&A) Manual, EIA Report of the TCNTE project and other relevant statutory requirements.

The construction of the Contract No. NL/2017/03 - Tung Chung New Town Extension – Reclamation and Advance Works (“Contract 1”) at TCE commenced on 9 July 2018.

The contract commencement date of Contract No. NL/2020/02 - Tung Chung New Town Extension – Salt Water Supply System (“Contract 2”) at TCE was 21 June 2021.

The contract commencement date of Contract No. NL/2020/03 - Tung Chung New Town Extension – Major Infrastructure Works in Tung Chung East (“Contract 3”) at TCE was 22 June 2021.

The contract commencement date of Contract No. NL/2020/04 - Tung Chung New Town Extension – Siu Ho Wan Fresh Water Service Reservoir and Associated Mainlaying Works (“Contract 4”) at TCE was 15 July 2021.

This is the Monthly EM&A report presenting the EM&A works carried out during the period from 1 to 30 September 2021 for the TCE Project in accordance with the Updated EM&A Manual.

A summary of monitoring and audit activities conducted in the reporting period is listed below:

Air Quality Monitoring                               5 sessions

Noise Monitoring                              5 sessions

Water Quality Monitoring                          13 sessions

Soft Shore Ecological Monitoring            1 session

Environmental Site Inspection

-        Contract 1                                     5 sessions

-        Contract 2                                     5 sessions

-        Contract 3                                     5 sessions

-        Contract 4                                     4 sessions



Environmental Management Meeting

-        Contract 1                                     1 session

-        Contract 2                                     1 session

-        Contract 3                                     1 session

-        Contract 4                                     1 session

Environmental auditing works, including weekly site inspections of construction works conducted by the ET, audit of works vessels, audit of implementation of Dolphin Watching Plan, Works Vessel Travel Route Plan, Silt Curtain Deployment Plan, Spill Response Plan and Waste Management Plan were conducted in the reporting period.  Based on the audit results and the observation for the reporting period, environmental pollution control and mitigation measures for the Project were properly implemented.

Breaches of Action and Limit Levels for Air Quality

No exceedance of Action and Limit Levels was recorded for construction air quality monitoring in the reporting period.

Breaches of Action and Limit Levels for Noise

No exceedance of Action and Limit Levels was recorded for construction noise monitoring in the reporting period.

Breaches of Action and Limit Levels for Water Quality

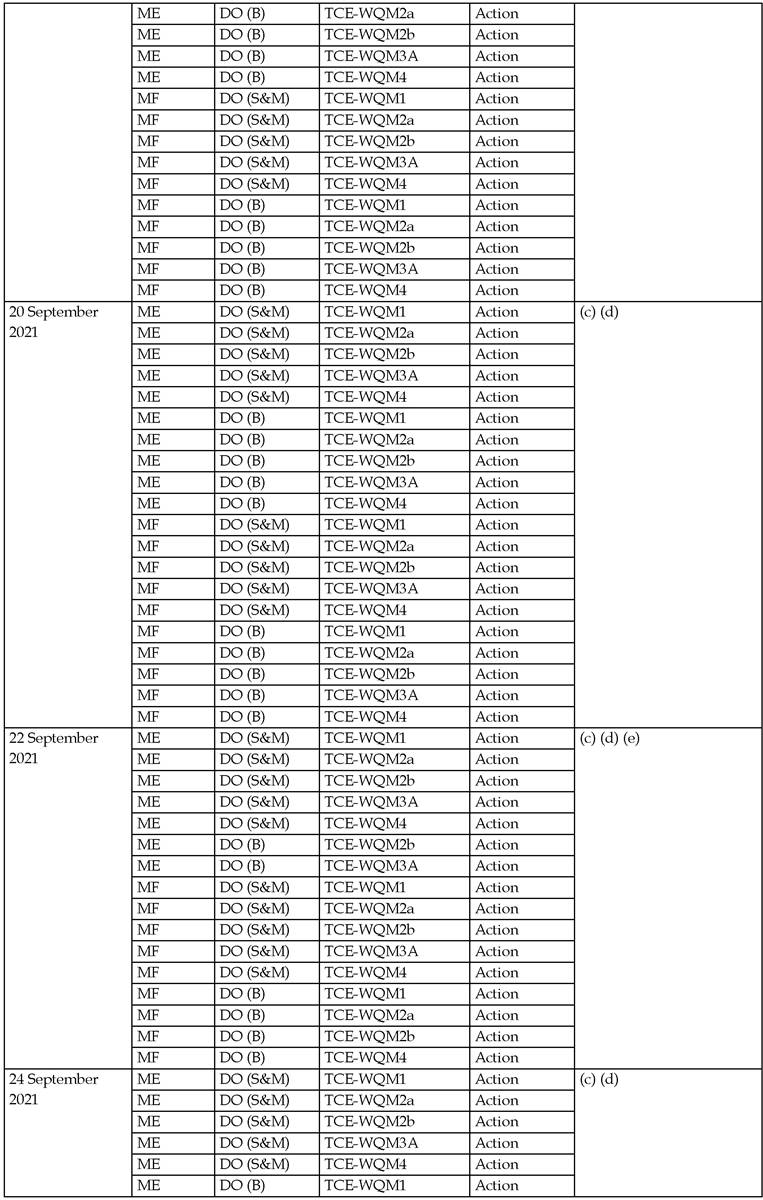

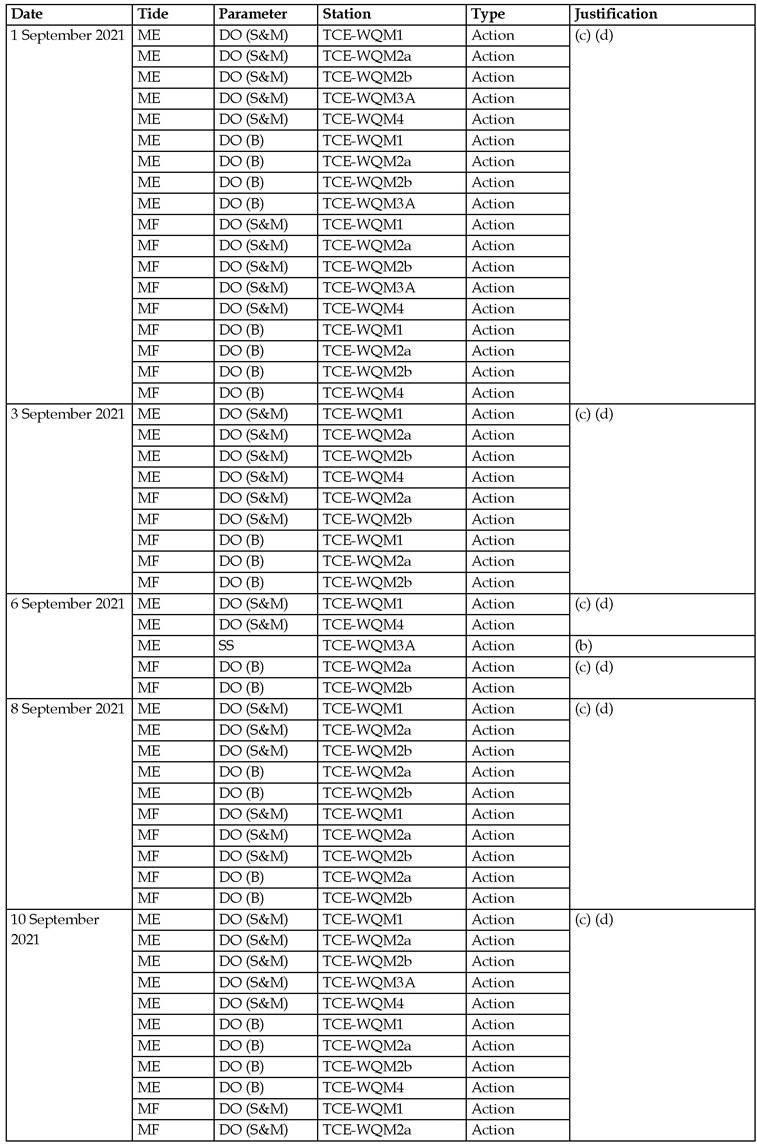

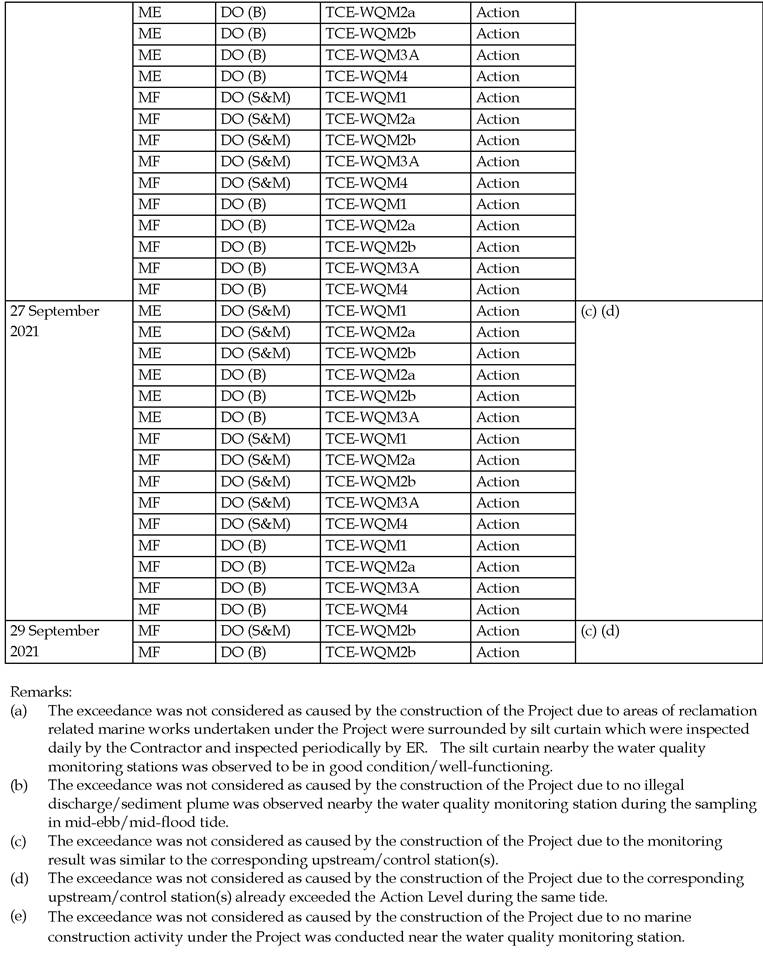

Dissolved Oxygen (DO) and Suspended Solids (SS) exceedances were recorded during the reporting period.  Relevant investigations and follow-up actions were conducted according to the EM&A programme.  The exceedances were considered not related to this Project after investigations.

Soft Shore Ecological Monitoring

Based on the impact monitoring conducted during the reporting period, there was no evidence showing any significant difference in intertidal communities when compared against the data obtained during baseline monitoring.  The ET will continue to observe the change in density or the distribution pattern of horseshoe crab, seagrass and intertidal soft shore communities taking into account natural fluctuation in respect of the occurrence and distribution pattern.

Environmental Complaints, Non-compliance & Summons

There was no notification of summons or prosecution recorded in the reporting period.

One (1) environmental complaint related to Contract 3 was received in the reporting period.  Investigation was conducted for the environmental complaint in accordance with the complaint handling process as stated in the Complaint Management Plan.

Reporting Change

There was no reporting change in the reporting period.

Key Issues For The Coming Month

Potential environmental impacts arising from the upcoming construction activities in the next reporting period of October 2021 are mainly associated with dust emission, noise from barge and plant operation during normal working hours and restricted hours, elevation in SS due to sediment loss from laying of sand blanket and marine filling works, disturbance to Chinese White Dolphin (CWD) during marine works, handling and storage of C&D materials generated from construction activities, efficiency of wastewater and drainage management and tree protection.  The ET will keep track on the construction works to confirm compliance of environmental requirements and the proper implementation of all necessary mitigation measures.  The ET will also recommend to the Contractor about the environmental toolbox topics on the abovementioned key issues for the coming month.




1                                    Introduction

1.1                               Background

Tung Chung New Town Extension (TCNTE) is one of the major initiatives under the Government's multi-pronged approach to increase land supply to meet Hong Kong's medium- to long-term needs for housing, economic and social developments. The Environmental Impact Assessment (EIA) Report for TCNTE (Register No. AEIAR-196/2016) was approved on 8 April 2016 and the Environmental Permit (EP) No. EP-519/2016, covering the construction and operation of TCNTE, was granted on 9 August 2016. The EIA Report and EP cover both Tung Chung East (TCE) and Tung Chung West (TCW).

ERM-Hong Kong, Limited (ERM) is commissioned to undertake the role of Environmental Team (ET) for the construction and operation of TCE Project (“the Project”) in accordance with the requirements specified in the EP, Updated Environmental Monitoring and Audit (EM&A) Manual ([1]), EIA Report of the TCNTE project ([2]) and other relevant statutory requirements.

The TCNTE comprises the following elements:

(a)     TCE Project

1.         Reclamation of the seabed by a non-dredged method at TCE to form a total of about 130 hectares of land;

2.         Construction of about 4.9 kilometers of seawalls, with an eco-shoreline , three drainage box culvert outfalls, three circulation drains and a seawater intake at TCE;

3.         Provision of infrastructure for Tung Chung Area 58, including construction of a single two-lane road with a footpath and the associated utility works;

4.         Construction of proposed open space;

5.         Construction of roads, footpaths, cycle tracks and the associated junction / road improvement works;

6.         Engineering infrastructure works covering drainage, sewerage, waterworks (including a fresh water service reservoir, a salt water service reservoir and a salt water pumping station), common utility tunnels and landscaping works; and

7.         Implementation of environmental mitigation measures and environmental monitoring and audit programme for the works.

(b)     TCW Project

1.         Site formation works at TCW;

2.         Construction of proposed open space;

3.         Construction of the River Park including a visitor centre at TCW; and

4.         Construction of sustainable urban drainage systems at TCW.

The locations of Contracts 1, 2, 3 and 4 are shown in Figure 1.1 to 1.4.  The construction and the reclamation related marine works of Contract 1 commenced on 9 and 13 July 2018, respectively.  The contract commencement dates of Contract 2, 3 and 4 were 21 June 2021, 22 June 2021 and 15 July 2021, respectively.

1.2                               Scope of the EM&A Report

This is the Monthly EM&A Report for the TCE Project which summarises the key findings of the EM&A programme during the reporting period from 1 to 30 September 2021 for the construction works.

1.3                               Organization Structure

The organization structure of the Project is shown in Annex A.  The key personnel contact names and contact details are summarized in Table 1.1 below.

Table 1.1        Contact Information of Key Personnel

Party

Position

Name

Telephone

Environmental Team (ET)

(ERM-Hong Kong, Limited)

ET Leader

Ray Yan

3894 9507

Deputy ET Leader

Kelvin So

3894 9504









Independent Environmental Checker (IEC)

(Binnies Hong Kong Limited)

IEC

Manuel Chua

3894 9501

Deputy IEC



Edward Lau

3894 9502



Contract No. NL/2017/03 - Tung Chung New Town Extension – Reclamation and Advance Works (Contract 1)

Civil Engineering and Development Department



Senior Engineer

Henry Cheung

2231 4508

Marine Conservation Officer



Wo King Tai

3894 9707

Engineer’s Representative

(ER)

(AECOM Asia Company Limited)



Principal Resident Engineer

Chief Resident Engineer

Frankie Fan



Chris Cheung

3894 9603



3894 9604

Resident Engineer

Nelson Ling

3894 9647

Senior Inspector of Works



C K Liu

3894 9733

Contractor

(Build King – SCT Joint Venture)



Site Agent

Keith Tse

3903 1503

Construction Team Leader

Dick Ip

9093 2409

Environmental Officer

Issac Wong

9850 0989

24-hour Complaint Hotline

-

9862 2910









Contract No. NL/2020/02 - Tung Chung New Town Extension – Salt Water Supply System (Contract 2)

Civil Engineering and Development Department



Senior Engineer

Bryan H M Ho

2231 4435

Electrical & Mechanical Engineer



Samson K L Yip

2231 4460

Engineer’s Representative

(ER)

(AECOM Asia Company Limited)



Principal Resident Engineer

Senior Resident Engineer

Frankie Fan



Sunny Ng

3894 9603



3894 9605

Senior Resident Engineer

Vincent Leung

3894 9645

Resident Engineer

Terence Chan

3894 9683

Senior Inspector of Works



Wong Ting Yu

3894 9706

Contractor

(China Geo-Engineering Corporation)



Construction Manager

Ambrose Kwong

6198 7787

Site Agent

Timothy Lo

9661 2662

Construction Team Leader

Edward Mok

6498 4306

Environmental Officer

Raymond Mui

9518 3610



24-hour Complaint Hotline (a)

-

5484 9233









Contract No. NL/2020/03 - Tung Chung New Town Extension – Major Infrastructure Works in Tung Chung East (Contract 3)

Civil Engineering and Development Department



Senior Engineer

Eddie W C Lam

2231 4445

Engineer

Timothy H M Chan

2231 4473

Engineer

S C Fung

2231 4461







Senior Engineer

S K Lo

2231 4426

Engineer

Colin K C Wong

2231 4417

Engineer

Stanley H K Lai

3894 9704









Engineer’s Representative

(ER)

(AECOM Asia Company Limited)



Principal Resident Engineer

Senior Resident Engineer

Frankie Fan



Boris Lo

3894 9603



3894 9650

Resident Engineer

David Li

3894 9684



Resident Engineer

Carl Yu

3894 9671



Senior Inspector of Works



Douglas Ng

3894 9737

Contractor

(Build King Civil Engineering Limited)



Construction Manager

Cheung Siu Lun

2272 3680

Site Agent

Paul Lui

2272 3680

Deputy Site Agent

Aldous Lo

9225 0368

Construction Team Leader

Ken Yau

9197 2219

Environmental Officer

Allen Wong

6012 2643



24-hour Complaint Hotline (a)

-

9862 2910

Contract No. NL/2020/04 - Tung Chung New Town Extension – Siu Ho Wan Fresh Water Service Reservoir and Associated Mainlaying Works (Contract 4)

Civil Engineering and Development Department



Senior Engineer

Jeffrey S M Lai

2231 4470

Engineer

Eric Leung

2231 4421

Engineer’s Representative

(ER)

(AECOM Asia Company Limited)



Principal Resident Engineer

Senior Resident Engineer

Frankie Fan



Sunny Ng

3894 9603



3894 9605



Senior Resident Engineer

Vincent Leung

3894 9645



Resident Engineer

Terence Chan

3894 9683



Senior Inspector of Works



Wong Ting Yu

3894 9706

Contractor

(China Geo-Engineering Corporation)



Construction Manager

Ambrose Kwong

6198 7787

Site Agent

Esmond Ng

9520 6809

Environmental Officer

Alfred Lau

6768 3100

24-hour Complaint Hotline (a)

-

2243 7132









Note: (a) The 24-hour complaint hotline is subjected for approval.

1.4                               Summary of Construction Works

As informed by the Contractor, details of the major works carried out in this reporting period are listed below:




Table 1.2        Major Activities in the Reporting Period

Activities

Key Issues

Key Mitigation Measures

Contract No. NL/2017/03 - Tung Chung New Town Extension – Reclamation and Advance Works (Contract 1)

Land-based Works





·        Ground investigation works

·        Land DCM works

·        Jet grouting works

·        Placing of sorted public fill

·        Box culvert construction

·        Installation of PVD

·        Dust emission

·        Handling and storage of C&D materials generated from construction activities

·        Noise from plant operation

·        Emission of dark smoke from PMEs

·        Efficiency of wastewater and drainage management

·        Good site practices

·        Regular water spraying on stockpiles, unpaved haul road and land filling area

·        Provide tarpaulin sheets coverage on stockpiles

·        Sorting and reuse of C&D materials as far as practicable

·        Use of QPME and noise barrier/acoustic mat

·        Regular maintenance of PMEs

·        Implementation of wastewater and drainage management

Marine-based Works





·        Laying of geotextile and sand blanket for reclamation works

·        Marine-based instruments monitoring works

·        Placing of sorted public fill

·        Seawall construction

·        Elevation in impact on Water Quality due to sediment loss from sand blanket laying and marine filling works

·        Potential surface runoff

·        Potential filling material drop from barges

·        Disturbance to Chinese White Dolphin

·        Noise from marine vessels and plant operation during normal working hours or restricted hours

·        Dust emission during storage and transfer of sand/ sorted public fill

·        Emission of dark smoke from marine vessel





·        Provision of perimeter silt curtain

·        Provision of a leading seawall of at least 200m before marine filling works

·        Regular cleaning of accumulated sand/fill materials at the edge of the barges

·        Implementation of Dolphin Watching for the marine-based works

·        Strictly follow requirement under CNP for the use of PMEs and works within restricted period

·        Use of acoustic mat and other noise mitigation measures when necessary

·        Regular maintenance of engines and mechanical equipment




Contract No. NL/2020/02 - Tung Chung New Town Extension – Salt Water Supply System (Contract 2)

Land-based Works





·        Initial survey (land survey prior to the commencement of construction works)

·        Hoarding erection

·        Pre-drilling

·        Tree survey

·        Utilities detection

·        Dust emission

·        Handling and storage of C&D materials generated from construction activities

·        Noise from plant operation

·        Emission of dark smoke from PMEs

·        Efficiency of wastewater and drainage management

·        Tree protection

·        Good site practices

·        Regular water spraying on stockpiles, unpaved haul road and land filling area

·        Provide tarpaulin sheets coverage on stockpiles

·        Sorting and reuse of C&D materials as far as practicable

·        Use of QPME and noise barrier/acoustic mat

·        Regular maintenance of PMEs

·        Implementation of wastewater and drainage management

·        Retain and protect all existing trees and vegetation within the study area which are not directly affected by the works

Contract No. NL/2020/03 - Tung Chung New Town Extension – Major Infrastructure Works in Tung Chung East (Contract 3)

Land-based Works





·        Initial survey (land survey prior to the commencement of construction works)

·        Tree survey

·        UU detection works

·        GI works at Portion 104

·        Sheetpile trial at Portion 12A and Portion 104

·        Dust emission

·        Handling and storage of C&D materials generated from construction activities

·        Noise from plant operation

·        Emission of dark smoke from PMEs

·        Efficiency of wastewater and drainage management

·        Tree protection

·        Good site practices

·        Regular water spraying on stockpiles, unpaved haul road and land filling area

·        Provide tarpaulin sheets coverage on stockpiles

·        Sorting and reuse of C&D materials as far as practicable

·        Use of QPME and noise barrier/acoustic mat

·        Regular maintenance of PMEs

·        Implementation of wastewater and drainage management

·        Retain and protect all existing trees and vegetation within the study area which are not directly affected by the works




Contract No. NL/2020/04 - Tung Chung New Town Extension – Siu Ho Wan Fresh Water Service Reservoir and Associated Mainlaying Works (Contract 4)



Land-based Works





·        Initial survey (land survey prior to the commencement of construction works)

·        Tree survey

·        Site clearance

·        Hoarding erection

·        Utilities detection



·        Dust emission

·        Handling and storage of C&D materials generated from construction activities

·        Noise from plant operation

·        Emission of dark smoke from PMEs

·        Efficiency of wastewater and drainage management

·        Tree protection

·        Good site practices

·        Regular water spraying on stockpiles, unpaved haul road and land filling area

·        Provide tarpaulin sheets coverage on stockpiles

·        Sorting and reuse of C&D materials as far as practicable

·        Use of QPME and noise barrier/acoustic mat

·        Regular maintenance of PMEs

·        Implementation of wastewater and drainage management

·        Retain and protect all existing trees and vegetation within the study area which are not directly affected by the works



The environmental mitigation implementation schedule is presented in Annex B.

1.5                               Summary of EM&A Programme Requirements

The status for all environmental aspects are presented in Table 1.3.  The EM&A requirements remained unchanged during the reporting period.

Table 1.3        Summary of Status for the Environmental Aspects under the Updated EM&A Manual

Parameters

Status

Air Quality

Baseline Monitoring

The results of baseline air quality monitoring for TCE were reported in Baseline Monitoring Report and submitted to EPD under EP Condition 3.4



Impact Monitoring

On-going for TCE, monitoring conducted three times every six days





Noise

Baseline Monitoring

The results of baseline noise monitoring for TCE were reported in Baseline Monitoring Report and submitted to EPD under EP Condition 3.4



Impact Monitoring

On-going for TCE, monitoring conducted once per week



Impact Monitoring for Road Traffic Noise during Operational Phase



To be conducted during operational phase

Fixed Noise Commissioning Test

To be implemented by the Contractor before operation of TCNTE





Water Quality

Baseline Monitoring

The results of baseline water quality monitoring for TCE were reported in Baseline Monitoring Report and submitted to EPD under EP Condition 3.4



Impact Monitoring

On-going for TCE, monitoring conducted three times per week





Waste Management

Waste Monitoring

On-going





Land Contamination

Contamination Assessment Plan (CAP), Remediation Action Plan (RAP) and Remediation Report (RR)

To be conducted under TCW. Refer to the EM&A Reports of TCW.





Ecology

Monitoring for Compensation Woodland



To be conducted when compensation woodland are planted

Monitoring for Emergent Plant inside the future River Park



To be conducted under TCW. Refer to the EM&A Reports of TCW.

Monitoring for Translocated Amphibians of Conservation Importance



To be conducted under TCW. Refer to the EM&A Reports of TCW.

Monitoring for Preserved/Transplanted Plant Species of Conservation Importance



To be conducted after preservation/ transplantation

Monitoring for Tung Chung Stream EIS and Wong Lung Hang EIS



To be conducted under TCW. Refer to the EM&A Reports of TCW.  Monitoring for Wong Lung Hang was not required and the proposal was accepted by EPD on 2 September 2021





Eco-shoreline Monitoring

To be conducted when eco-shoreline at TCE PDA and Road P1 is built



Tung Chung Bay and Tai Ho Wan Baseline Monitoring

The results of baseline soft shore ecological monitoring at Tung Chung Bay and Tai Ho Wan were reported in Baseline Monitoring Report and submitted to EPD under EP Condition 3.4



Tung Chung Bay and Tai Ho Wan Impact Monitoring

On-going for TCE, monitoring conducted quarterly





Landscape and Visual



Baseline Monitoring

The results of baseline landscape and visual monitoring were reported in Baseline Monitoring Report and submitted to EPD under EP Condition 3.4





Site Environmental Audit

Regular Site Inspection



On-going

Dolphin Watching Plan implementation measures



Under implementation by the Contractor of Contract 1

Works Vessel Travel Route Plan implementation measures



Under implementation by the Contractor of Contract 1

Silt Curtain Deployment Plan implementation measures

Under implementation by the Contractor of Contract 1





Spill Response Plan implementation measures

Under implementation by the Contractor of Contract 1





Waste Management Plan implementation measures

Under implementation by the Contractor of Contract 1





Complaint Hotline and Email Channel



Under implementation by the Contractor of Contracts 1.

The 24-hour complaint hotline/email channel under Contracts 2, 3, and 4 are subjected for approval





Environmental Log Book

On-going

Taking into account the construction works, impact monitoring of air quality, noise, water quality, soft shore ecological monitoring and waste management were carried out in the reporting period.  The monitoring schedule of air quality, noise, water quality monitoring and soft shore ecological monitoring are provided in Annex E2, Annex F2, Annex G2 and Annex H1, respectively.

The EM&A programme also involved environmental site inspections and related auditing conducted by the ET for checking the implementation of the required environmental mitigation measures recommended in the approved EIA Report and relevant EP submissions, including Dolphin Watching Plan, Works Vessel Travel Route Plan, Silt Curtain Deployment Plan, Spill Response Plan and Waste Management Plan.

To promote the environmental awareness and enhance the environmental performance of the contractors, environmental trainings and regular environmental management meetings were conducted during the reporting period, which are summarized as below:

Ÿ   Four (4) environmental management committee meetings were held with the Contractors of Contract 1 and 4 and ER, ET, IEC and CEDD on 24 and 13 September, respectively, and Contractors of Contract 2 and 3 on 15 September 2021;

Ÿ   Environmental toolbox trainings on wastewater handling, Work Vessel Travel Route Plan, handling of chemical spillage and Construction Noise Permit on 3, 8, 17, 24 and 29 September 2021 were conducted for Contract 1;

Ÿ   Environmental toolbox training on construction dust and suppression on 29 September 2021 was conducted for Contract 2;

Ÿ   Environmental toolbox training on housekeeping, waste collection, handling and disposal, construction noise and suppression, the use of wetsep and chemical waste container, chemical waste management, construction waste management and dust mitigation measures on 6, 13, 16, 20, 23, 27 and 30 September 2021 was conducted for Contract 3;

Ÿ   Environmental toolbox trainings on housekeeping, dust mitigation measures within site access, site boundary and haul road, dust and noise mitigation measures during excavation on 10, 17 and 24 September 2021 were conducted for Contract 4.

1.6                               Status of Statutory Environmental Compliance with the Environmental Permit

The status of statutory environmental compliance with the EP conditions under the EIAO, submission status under the EP and implementation status of mitigation measures are presented in Annex C

1.7                               Status of Other Statutory Environmental Requirements

The environmental licenses and permits, including environmental permit, waste discharge license, registration as chemical waste producer and construction noise permit, which were valid in the reporting period are presented in Annex D.  No non-compliance with environmental statutory requirements was recorded.





2                                    EM&A Results for Tung Chung East

The EM&A programme for the Project required environmental monitoring for air quality, noise, water quality and marine ecology as well as environmental site inspections for air quality, noise, water quality, waste management, marine ecology and landscape and visual impacts.  The EM&A requirements and related findings for each component are summarized in the following sections.

2.1                               Air Quality

2.1.1                          Monitoring Requirements and Equipment

According to the Updated EM&A Manual of the Project, impact air quality monitoring in terms of 1-hour Total Suspended Particulate (TSP) was conducted three (3) times every six (6) days when the highest dust impact was expected.  The Action and Limit Levels of the air quality monitoring is provided in Table 2.1 below.

Table 2.1        Action and Limit Levels for 1-hour TSP

Location

Action Level, µg/m3

Limit Level, µg/m3

Monitoring station for Tung Chung East

279

500

Portable direct reading dust meters were used to measure 1-hour TSP levels in undertaking the air quality monitoring for the Project.  The proposed use of portable direct reading dust meters was submitted to IEC and obtained agreement from the IEC as stated in Section 5.5 of the Updated EM&A Manual.  With the use of direct reading dust meter, it can allow prompt and direct results for the EM&A reporting and the implementation of the event and action plan.  The portable direct reading dust meter would be calibrated every year against High Volume Sampler (HVS) to check the validity and      accuracy of the results measured by direct reading method.

The monitoring location and equipment used in the impact air quality monitoring programme are summarized in Table 2.2 and illustrated in Figure 2.1.  Copies of the calibration certificates for the equipment are presented in Annex E1, which showed that the portable direct reading dust meter is capable of providing comparable results with that provided by a HVS.





Table 2.2        Air Quality Monitoring Details

Monitoring Station

Location

Parameter

Frequency and Duration

Monitoring Dates

Equipment

DM-1

Tung Chung Area 56 – Ying Tung Estate

1-hour TSP

Three times per six days during the construction period of the Project

6, 11, 17, 23 and 29 September 2021

1-hour TSP Dust Meter

SIBATA LD-3B (S/N: 276017)

Remark:

It should be noted that impact monitoring at other construction dust monitoring locations at TCE as stated in the Updated EM&A Manual will commence after the flat intake (for Monitoring Stations DM-2, DM-3 and DM-4).

2.1.2                          Monitoring Schedule for the Reporting Month

The schedule for air quality monitoring during the reporting period is provided in Annex E2.

2.1.3                          Results and Observations

The monitoring results for 1-hour TSP are summarized in Table 2.3.  The monitoring data and the graphical presentation are provided in Annex E3.

Table 2.3        Summary of 1-hour TSP Monitoring Results in the Reporting Period

Monitoring Station

Average (µg/m3)

Range (µg/m3)

Action Level  (µg/m3)

Limit Level  (µg/m3)

DM-1

45

20-56

279

500

The dust sources in the reporting period included haul road traffic, unloading of sand/fill material, filling works and operation of marine vessels under the Project.

No exceedance of Action and Limit Levels was recorded for construction air quality monitoring in the reporting period.  No action was thus required to be undertaken in accordance with the Event and Action Plan presented in Annex E4.

2.2                               Noise Monitoring

2.2.1                          Monitoring Requirements and Equipment

According to the Updated EM&A Manual of the Project, impact noise monitoring was conducted once per week during the construction phase of the Project.  The Action and Limit Level for construction noise of the Project is provided in Table 2.4 below.

Table 2.4        Action and Limit Levels for Construction Noise

Time Period

Action Level

Limit Level

0700 - 1900 hours on normal weekdays

When one documented complaint is received

75 dB(A) *

Notes:

Limit level is exceeded when Leq ≥ 75 dB(A).  If works are to be carried out during restricted hours, the conditions stipulated in the construction noise permit issued by the Noise Control Authority have to be followed.

* Reduce to 70 dB (A) for schools and 65 dB (A) during school examination periods.

Noise monitoring was performed using sound level meter at the designated monitoring stations NMS-CA-1A ([3]) ([4]) and NMS-CA-4 (Figure 2.2; Table 2.5) in accordance with the requirements stipulated in the Updated EM&A Manual.  Acoustic calibrator was deployed to check the sound level meters at a known sound pressure level.  Details of the deployed equipment are provided in Table 2.5.  Copies of the calibration certificates for the equipment are presented in Annex F1

Table 2.5        Noise Monitoring Details

Monitoring Station (a)

Location

Parameter

Frequency and Duration

Monitoring Dates

Equipment

NMS-CA-1A (b)

Residential premise in Tung Chung East – Century Link/Ying Hong Road (c)



30-minute measurement between 0700 and 1900 on normal weekdays (Monday to Saturday). Leq, L10 and L90 would be recorded.

Once per week for 30 mins during the construction period of the Project

6, 11, 17, 23 and 29 September 2021

Sound Level Meter: Rion NL-52 (S/N: 00175561)



Acoustic Calibrator: LARSON DAVIS CAL200 (S/N: 10227)

NMS-CA-4

Residential premise in the reclamation area next to Tung Chung East – Ying Tung Estate





Remarks:

(a)     It should be noted that impact monitoring at other construction noise monitoring locations at TCE as stated in the Updated EM&A Manual will commence after the flat intake of residential premise in TCE (for Monitoring Station NMS-CA-1) and operation of schools (for Monitoring Stations NMS-CA-2 and NMS-CA-3).

(b)     Impact monitoring at monitoring station NMS-CA-1A commenced on 19 September 2018 in view of the close vicinity of the construction works near the residential area at Century Link.

(c)     Due to land handover issue, NMS-CA-1A was relocated to Ying Hong Road which is located 60m away from the original location.  Proposal on the relocation of NMS-CA-1A was approved by IEC on 23 November 2018.  Noise monitoring at the relocated location commenced since 24 November 2018.

2.2.2                          Monitoring Schedule for the Reporting Month

The schedule for noise monitoring during the reporting period is provided in Annex F2.

2.2.3                          Results and Observations

Results for noise monitoring are summarized in Table 2.6.  The monitoring data and the graphical presentation are provided in Annex F3.

Table 2.6        Summary of Construction Noise Monitoring Results in the Reporting Period

Monitoring Station

Average , dB(A),

Leq (30mins)

Range, dB(A),

Leq (30mins)

Limit Level, dB(A),

Leq (30mins)

NMS-CA-1A

68.1

67.1-69.0

75

NMS-CA-4

64.9

64.4-65.5

75

Major noise sources during the noise monitoring included noise from barge and plant operation, craning, haul road traffic, nearby traffic and aircraft as well as nearby construction sites.



No Action and Limit Level exceedance was recorded for construction noise monitoring in the reporting period.

2.3                               Water Quality Monitoring

2.3.1                          Monitoring Requirements and Equipment

Impact water quality monitoring was carried out to ensure that any deterioration of water quality was detected, and that timely action was taken to rectify the situation.  Impact water quality monitoring was undertaken three days per week since the commencement of marine works during the reporting period in accordance with the Updated EM&A Manual.  Each impact water quality monitoring was scheduled such that the interval between two impact water quality monitoring was more than 36 hours to record representative water quality data throughout the week during the marine works.

Two (2) replicate in-situ measurements and samples were collected at each monitored water depth of each designated monitoring stations.  Dissolved Oxygen (DO), pH value, salinity, temperature and turbidity were measured in-situ whereas the level of suspended solids (SS) were determined by ALS Technichem (HK) Pty Ltd which is a HOKLAS accredited laboratory.

The Action and Limit Levels of the water quality monitoring are provided in Table 2.7.

Table 2.7        Action and Limit Levels for Water Quality

Parameters

Action Level

Limit Level

DO in mg/L

(Surface, Middle & Bottom)

Surface and Middle

5.9 mg/L [1]



Bottom

5.6 mg/L

Surface and Middle

4 mg/L [1]



Bottom

2 mg/L



SS in mg/L (Depth-averaged)

13.5 mg/L
or
120% of upstream control station at the same tide of the same day, whichever is higher. [2]





23.5 mg/L
or
130% of upstream control station at the same tide of the same day, whichever is higher. [2]

Turbidity in NTU (Depth-averaged)

17.1 NTU
or
120% of upstream control station at the same tide of the same day, whichever is higher. [2]

23.5 NTU
or
130% of upstream control station at the same tide of the same day, whichever is higher. [2]

Notes:

(1)       For DO, non-compliance occurs when monitoring results is lower than the limits.

(2)       For SS and Turbidity, non-compliance occurs when monitoring results is larger than the limits

The locations of the monitoring stations under the Project are shown in Figure 2.3 and Table 2.8.

Table 2.8        Locations of Impact Water Quality Monitoring Stations and the Corresponding Monitoring Requirements

Monitoring Station

Description

Coordinates

Parameters (a)

Frequency

Monitoring Dates

Depth





Easting

Northing







TCE-WQM1

Near Airport Channel

811838

817341

Ÿ Dissolved Oxygen (DO) (mg/L and % saturation)

Ÿ Temperature (°C)

Ÿ Turbidity (NTU)

Ÿ Salinity (ppt)

Ÿ pH

Ÿ Water depth (m)

Ÿ Suspended Solid (SS) (mg/L)

Impact monitoring: 3 days per week, at mid-flood and mid-ebb tides during the construction period of the Project



1, 3, 6, 8, 10, 13, 15, 17, 20, 22, 24, 27 and 29 September 2021

3 water depths: 1m below sea surface, mid-depth and 1m

above seabed.  If the water depth is less than 3m, mid-depth sampling only.  If water depth less than 6m, mid-depth may be omitted

TCE-WQM2a

Marine Park 1

814439

819879

TCE-WQM2b

Marine Park 2

814439

821905

TCE-WQM3A

Outlet of Tai Ho Wan

814705

817859

TCE-WQM4

HKBCF

813344

818849

TCE-C1

Control Station - Outside Airport Channel

804247

815620

TCE-C2

Control Station - Sunny Bay

819460

821473



Notes:



(a)    In addition to the abovementioned parameters, other relevant data shall also be recorded, including monitoring location / position, time, water depth, tidal stages, weather conditions and any special phenomena or work underway at the construction site.

Table 2.9 summarizes the equipment used in the impact water quality monitoring works.  Copies of the calibration certificates are attached in Annex G1.




Table 2.9        Water Quality Monitoring Equipment

Equipment

Model

Water Sampler

Kahlsico Water Samplers

Multi-parameter Water Quality System (measurement of DO, Temperature, Turbidity, Salinity and pH)

YSI ProDSS (S/N: 15M100005, 16H104233, 16H104234, 18A104824)



2.3.2                          Monitoring Schedule for the Reporting Month

The schedule for water quality monitoring during the reporting period was provided in Annex G2

2.3.3                          Results and Observations

A total of 13 monitoring events for impact water quality monitoring were conducted at all designated monitoring stations during the reporting period.  Impact water quality monitoring results and graphical presentations were provided in Annex G3

Action level exceedances were recorded for water quality impact monitoring in the reporting period and the event and action plan (Annex G4) was undertaken.  Investigations on the action level exceedances were conducted and summarized in Table 2.10 below.







Table 2.10         Details of Exceedances Recorded for Water Quality Monitoring



Pages from 0445700_Monthly EM&A Sep 21_v1_Page_1
Pages from 0445700_Monthly EM&A Sep 21_v1_Page_3
Pages from 0445700_Monthly EM&A Sep 21_v1_Page_4



Based on the investigations conducted for each of the monitoring day with exceedances, the exceedances of DO and SS were not likely caused by the work activities related to the Project.

In addition, low levels of DO were recorded during previous three summer periods.  This further suggested that exceedances of DO are likely caused by seasonal fluctuation and a similar trend of lower levels of DO would likely occur again during this summer period.

Nevertheless, the Contractors were reminded to implement all relevant mitigation measures for the marine works, including regular checking of silt curtain integrity, provide periodic maintenance and maintain good site practice.  The ET will keep on checking monitoring data, plant, equipment and Contractor’s working methods.

2.4                               Soft Shore Ecological Monitoring

2.4.1                           Monitoring Requirements

According to the Updated EM&A Manual of the Project, impact soft shore ecological monitoring has to be conducted quarterly at each survey location at Tung Chung Bay (TCB) and Tai Ho Wan (THW) covering wet and dry seasons during the marine construction of the Project.  The soft shore ecological monitoring consisted of qualitative walk-through surveys, quantitative transect surveys and sedimentation rate monitoring at the accessible survey locations of TCB and THW.

For qualitative walk-through surveys, the accessible shoreline of TCB and THW at each of the three shore heights: 2 m, 1.5 m and 1 m above Chart Datum was surveyed, and organisms encountered were recorded and their relative abundance noted.  In particular, active search of horseshoe crabs and seagrasses were conducted to confirm whether these species are present along the sites.

For quantitative transect survey, one 50 – 100 m horizontal (belt) transect (actual length subject to the site conditions) was surveyed at each of the three shore heights: 2 m, 1.5 m and 1 m above Chart Datum of each survey location.  On each transect, five quadrats (50 cm x 50 cm) were placed randomly in each transect to assess the abundance and distribution of flora and fauna.  For each quadrat, surface layer to 5 cm depth was sieved and microbenthic organisms (e.g. crustaceans) were recorded and identified.  Density of organisms was expressed as individuals / m2.  Areas with seagrass were also recorded and identified and other information, such as the percentage cover, were also recorded.  Sessile animals such as barnacles and oysters in each quadrat were not counted but estimated as percentage cover on the rock surface.  All species of algae (encrusting, foliose and filamentous) were also identified and recorded by estimating the percentage cover on the rock surface.  All organisms were identified to the lowest possible taxonomic level (at least Genus level).  Species encountered outside the quadrat but in the vicinity of survey transect were also recorded.

For sedimentation rate monitoring, to avoid disturbance to the mudflat and nuisance to navigation, no fixed marker/monitoring rod was installed at the monitoring stations.  A high precision Global Navigation Satellite System (GNSS) real time location fixing system was used to locate the station in the precision of 1 mm, which is reasonable under flat mudflat topography with uneven mudflat surface only at micro level.

Measurements were taken directly on the mudflat surface.  The Real Time Kinematic GNSS (RTK GNSS) surveying technology was used to measure mudflat surface levels and 3D coordinates of a survey point.  The RTK GNSS survey was calibrated against a reference station in the field before and after each survey.  The reference station is a survey control point established by the Lands Department of the HKSAR Government using professional surveying instruments such as total station, level and geodetic global navigation satellite system.  The coordinates system is in HK1980 GRID system.  The reference station was surveyed and established by traditional land surveying methods using professional surveying instruments such as total station, level and geodetic GNSS.  The accuracy was down to mm level and higher than the proposed RTK GNSS cm level so that the reference control station has relatively higher accuracy.  As the reference control station has higher accuracy, it was set as true evaluation relative to the RTK GNSS measurement.  All position and height correction were adjusted and corrected to the reference control station.

The precision of the measured mudflat surface level reading (vertical precision setting) was within 10 mm (standard deviation) after averaging the valid survey records of the XYZ HK1980 GRID coordinates.  Each survey record at each station was computed by averaging at least three measurements that are within the above specified precision setting.  Both digital data logging and written records were collected in the field.  Field data on station fixing and mudflat surface measurement were recorded.

2.4.2                           Monitoring Schedule for the Reporting Month

The schedule for soft shore ecological monitoring during the reporting period is provided in Annex H1

2.4.3                           Results and Observations

Impact soft shore ecological monitoring was conducted at three (3) monitoring locations at Tung Chung Bay (TCB), situated in the eastern side (TCB1), southern side (TCB2) and western side (TCB3) as well as one (1) monitoring location at Tai Ho Wan (THW) as shown in Figure 2.4 during the reporting period.  Representative photographs taken during the impact monitoring are presented in Figure 2.5.

For qualitative walk-through surveys, horseshoe crabs and intertidal soft shore communities were recorded during the impact monitoring.  The survey results for each monitoring location are summarized in Table 2.11 below and detailed in Annex H2.



Table 2.11      Summary of Qualitative Walk-through Surveys

Location



Horseshoe Crabs

Seagrass

No. of Other Intertidal Species

Date and Time (1)

No. of Species

No. of Individuals

No. of Species

Area Coverage (m2)

TCB1



6/9/2021
13:00-17:30

1

6

-

-

47

TCB2



16/9/2021
09:30-13:30

1

3

-

-

45



TCB3

20/9/2021
13:00-17:30

1



17



1

144.5



37

THW



17/9/2021
10:00-13:30

1

21

-

-

50

Note:

(1)          Quantitative and qualitative transect surveys were conducted on 6 September 2021 at TCB1, 16 September 2021 at TCB2, 20 September 2021 at TCB3 and 17 September 2021 at THW.

For the quantitative transect surveys, a total of 4,787 individuals were recorded from all transects at monitoring stations TCB1, TCB2, TCB3 and THW.  The most abundant group of intertidal soft shore communities recorded was gastropods, with a total of 4,669 individuals (relative abundance of 97.6% and density of 311.3 individual m-2).  The summary of the top three dominant species at each shore height of each monitoring station and the complete list of species and density recorded are presented in Annex H2.  When compared with the results obtained during the baseline monitoring as presented in the Baseline Monitoring Report ([5]), there was no indication of a change in the composition of intertidal communities recorded during the reporting period.

The mudflat surface levels at the four selected monitoring stations in September 2021 and the corresponding XYZ HK1980 GRID coordinates are presented in Table 2.12.  When compared with the results obtained during the baseline monitoring as presented in the Baseline Monitoring Report (1), slight changes with <0.05 mPD of sediment levels are recorded for the monitoring stations.  The ET will continue to observe the trend of change in sediment levels over time for further comparison and review.

Table 2.12      Results of Sedimentation Rate Monitoring

Monitoring Station

Northing (m)

Easting (m)

Z level at June 2021 (mPD)

Remarks

TCB1

816068.733

811129.225

1.297

Soft mudflat

TCB2

815812.714

810917.373

1.112

Soft mudflat

TCB3

816027.414

810696.190

1.086

Soft mudflat

THW

817470.868

815849.926

1.044

Soft mudflat

Based on the impact monitoring results, there was no evidence showing any significant difference in intertidal communities when compared against the data obtained during baseline monitoring.  No action is thus required to be undertaken in accordance with the Event and Action Plan presented in Annex H3.  The ET will continue to observe the change in density or the distribution pattern of horseshoe crab, seagrass and intertidal soft shore communities taking into account natural fluctuation in respect of the occurrence and distribution pattern.

2.5                               EM&A Site Inspection

Site inspections were carried out on a weekly basis with the Contractor and ER to monitor the implementation of proper environmental pollution control and mitigation measures for air quality, noise, water quality, waste management, marine ecology and landscape and visual impacts under the Project.  In the reporting period, five (5) site inspections were carried out on 2, 9, 16, 24 and 30 September 2021 for Contract 1, five (5) site inspections were carried out on 1, 8, 15, 20 and 29 September 2021 for Contract 2, five (5) site inspections were carried out on 3, 10, 15, 24 and 30 September 2021 for Contract 3 and four (4) site inspections were carried out on 6, 13, 20 and 27 September 2021 for Contract 4.

Key observations during the site inspections are summarized in Table 2.13.

Table 2.13   Key Observations Identified during the Site Inspection in this Reporting Month

Contract No.

Inspection Date

Environmental Observations

Recommendations/ Remarks

Contract 1

2 September 2021



Tung Chung Reclamation Area (Near Berth No.3)

Ÿ  Defects of gaps were observed in the silt curtain.

Tung Chung Reclamation Area (Near Berth No.3)

Ÿ   The Contractor was urged to carry out maintenance.

9 September 2021



Tung Chung Reclamation Area (Area C1 & C2)

·        Dust was observed generated from unpaved road.

Tung Chung Reclamation Area (Area C1 & C2)

Ÿ   The Contractor was reminded to carry out dust mitigation measures such as watering.

16 September 2021

Tung Chung Reclamation Area (Near Berth No.3)

Ÿ  No deficiency was observed.

Ÿ   Nil.

24 September 2021

Tung Chung Reclamation Area (Near Pak Mong)

Ÿ   The silt curtain was observed not aligned with the Silt Curtain Deployment Plan.

Tung Chung Reclamation Area (Near Pak Mong)

Ÿ   The Contractor was urged to carry out maintenance.

30 September 2021

Interim Open Rectangular Channel (IORC)

Ÿ  Dust was observed generated from unpaved road.



Ÿ  Chemical containers were observed not placed in drip tray.



Ÿ  Non-road Mobile Machinery (NRMM) label was not observed on the generator.

Interim Open Rectangular Channel (IORC)

Ÿ  The Contractor was reminded to carry out dust mitigation measures such as watering.

Ÿ  The Contractor was reminded to place chemical containers in drip tray.

Ÿ  The Contractor was reminded to provide NRMM label.

Contract 2

1 and 8 September 2021



Portion 3, Portion 6

Ÿ   No deficiency was observed.

Ÿ   Nil.

15 September 2021

Portion 3

Ÿ   General refuse was observed.

Portion 3

Ÿ   The Contractor was reminded to clear the general refuse.

20 September 2021

C2(WA2,WA3)

Ÿ   No deficiency was observed.

Ÿ   Nil.

29 September 2021



Portion 3, Portion 6

Ÿ  No deficiency was observed.

Ÿ   Nil.

Contract 3

3 September 2021



Portion 104, Portion 12A

Ÿ   NRMM labels were not observed on the generator.

Portion 104, Portion 12A

Ÿ   The Contractor was reminded to provide NRMM labels.

10 September 2021

Portion 8, C3 temporary site office

Ÿ   General refuse was observed.

Portion 8, C3 temporary site office

Ÿ   The Contractor was reminded to clear the general refuse.

15 September 2021

Portion 12A

Ÿ   Dry haul road was observed.

Portion 12A

Ÿ   The Contractor was urged to apply dust mitigation measure such as watering.

24 September 2021

Portion 104, 16A-1, 16B-1, 12A

Ÿ   No deficiency was observed.

Ÿ   Nil.

30 September 2021

Portion 12A

Ÿ  No deficiency was observed.

Ÿ  Nil.

Contract 4

6, 13, 20 and 27 September 2021



Portion 1, WA5

Ÿ   No deficiency was observed.

Ÿ   Nil.

The Contractors have rectified all of the observations identified during environmental site inspections in the reporting period.  The Contractors were reminded to implement all relevant mitigation measures related to construction dust, construction noise, water quality and waste management outlined in the EIA Report and EM&A Manual.

2.6                               Waste Management Status

The Contractors of Contract 1, 2, 3 and 4 have registered as chemical waste producer.  Sufficient numbers of receptacles were available for general refuse collection and sorting.

All dump trucks engaged on site was equipped with RTTM system during the reporting period.  The Surveillance Team of the ET conducted regular site inspection on the dump trucks and their track records.  No illegal dumping and landfilling of C&D materials was found during the reporting period.

Wastes generated during this reporting period include mainly non-inert construction wastes.  Reference has been made to the waste flow tables prepared by the Contractors.  The quantities of different types of wastes and imported fill materials are summarised in Table 2.14

Table 2.14         Quantities of Different Waste Generated and Imported Fill Materials

Contract No.

Month/

Year

Inert C&D Materials (a)  (m3)

Imported Fill (d) (f) (sand) (m3)

Imported Fill (d) (public fill) (m3)

Inert Construction Waste Re-used

(m3)

Non-inert Construction Waste (b) (m3)

Recyclable Materials (c) (kg)

Chemical Wastes (kg)





Contract 1 (e)

1 to 31 Jul 21

0

94,099

142,234

0

97.0

0

0

1 to 31 Aug 21

0

11,897

233,776

0

88.0

351

0

1 to 30 Sep 21

0

36,120

299,715

0

103.0

281

2,400

Contract 2

1 to 31 Jul 21

0

0

0

0

0

0

0

1 to 31 Aug 21

0

0

0

0

4.4

0

0

1 to 30 Sep 21

0

0

0

0

15.9

0

0

Contract 3

1 to 31 Jul 21

0

0

0

0

0

0

0

1 to 31 Aug 21

0

0

0

0

8.0 (g)

0

0

1 to 30 Sep 21

0

0

0

0

1.0

125

0

Contract 4

1 to 31 Jul 21

0

0

0

0

0

0

0

1 to 31 Aug 21

0

0

0

0

0

0

0

1 to 30 Sep 21

0

0

0

0

0

0

0

Notes:





(a) Inert construction wastes include hard rock and large broken concrete, and materials disposed as public fill.

(b) Non-inert construction wastes include general refuse disposed at landfill.

(c) Recyclable materials include metals, paper, cardboard, plastics and others.

(d) Imported fill materials include sand and public fill.

(e) Imports fill materials under Contract 1 including mainly sand and public fill.  The Project imports fill materials including mainly sand and public fill.

(f) 2,848 m3 glass cullet was imported in the reporting period (September 2021).

(g) Updated figure is presented.

2.7                               Implementation Status of Environmental Mitigation Measures

A summary of the Environmental Mitigation Implementation Schedule is presented in Annex B.  The necessary mitigation measures were implemented properly for the Project.

2.8                               Summary of Exceedances of the Environmental Quality Performance Limit

The monitoring results for air quality monitoring (1-hour TSP) and construction noise monitoring complied with the Action/ Limit levels in the reporting period.

Action level exceedances were recorded for water quality impact monitoring in the reporting period.  The investigations on the action level exceedances were conducted and the results were summarized in Section 2.3.3

Cumulative statistics on exceedances is provided in Annex I.

2.9                               Summary of Complaints, Notification of Summons and Successful Prosecutions

There was no notification of summons or prosecution recorded in the reporting period.

One (1) environmental complaint related to Contract 3 was received in the reporting period.  Investigation was conducted for the environmental complaint in accordance with the complaint handling process as stated in the Complaint Management Plan.  Environmental complaint in the reporting period are summarized below.



Complaint(s)

Investigation/Follow up action(s)

1

Environmental complaint related to construction dust was referred by CEDD on 13 September 2021.

Based on the video provided by the complainant, it was confirmed that the road section mentioned in the complaint was the main haul road under Contract 3.  Based on the information provided by the Contractor and observation from regular site inspection, Contractor have deployed water trucks for water spraying every hour for dust suppression.  In addition to the watering provided, the captioned haul road was paved to reduce dust dispersion.  Nevertheless, dust were likely to arise occasionally when under hot / dry weather.  Contractor was reminded to review the effectiveness of the watering efficiency of the water trucks arrangement and introduce enhancement as appropriate in order to minimize the nuisance to the public.

Statistics on complaints, notifications of summons, successful prosecutions are summarised in Annex I.

3                 Future Key Issues

3.1                               Construction Programme for the Coming Month

Works to be undertaken in the next monitoring period of October 2021 are summarized in Table 3.1 below, together with the key issues and the key mitigation measures:



Table 3.1        Major Activities for the Next Reporting Period

Activities

Key Issues

Key Mitigation Measures

Contract No. NL/2017/03 - Tung Chung New Town Extension – Reclamation and Advance Works (Contract 1)

Land-based Works





·        Ground investigation works

·        Land DCM works

·        Jet grouting works

·        Placing of sorted public fill

·        Box culvert construction

·        Installation of PVD

·        Dust emission

·        Handling and storage of C&D materials generated from construction activities

·        Noise from plant operation

·        Emission of dark smoke from PMEs

·        Efficiency of wastewater and drainage management

·        Good site practices

·        Regular water spraying on stockpiles, unpaved haul road and land filling area

·        Provide tarpaulin sheets coverage on stockpiles

·        Sorting and reuse of C&D materials as far as practicable

·        Use of QPME and noise barrier/acoustic mat

·        Regular maintenance of PMEs

·        Implementation of wastewater and drainage management

Marine-based Works





·        Laying of geotextile for seawall construction

·        Marine-based instruments monitoring works

·        Placing of sorted public fill

·        Seawall construction

·        Elevation in impact on Water Quality due to sediment loss from sand blanket laying and marine filling works

·        Potential surface runoff

·        Potential filling material drop from barges

·        Disturbance to Chinese White Dolphin

·        Noise from marine vessels and plant operation during normal working hours or restricted hours

·        Dust emission during storage and transfer of sand/ sorted public fill

·        Emission of dark smoke from marine vessel





·        Provision of perimeter silt curtain

·        Provision of a leading seawall of at least 200m before marine filling works

·        Regular cleaning of accumulated sand/fill materials at the edge of the barges

·        Implementation of Dolphin Watching for the marine-based works

·        Strictly follow requirement under CNP for the use of PMEs and works within restricted period

·        Use of acoustic mat and other noise mitigation measures when necessary

·        Regular maintenance of engines and mechanical equipment




Contract No. NL/2020/02 - Tung Chung New Town Extension – Salt Water Supply System (Contract 2)

Land-based Works





·        Initial survey (land survey prior to the commencement of construction works)

·        Hoarding erection

·        Pre-drilling

·        Piling works

·        Tree survey

·        Utilities detection

·        Site clearance

·        Dust emission

·        Handling and storage of C&D materials generated from construction activities

·        Noise from plant operation

·        Emission of dark smoke from PMEs

·        Efficiency of wastewater and drainage management

·        Tree protection

·        Good site practices

·        Regular water spraying on stockpiles, unpaved haul road and land filling area

·        Provide tarpaulin sheets coverage on stockpiles

·        Sorting and reuse of C&D materials as far as practicable

·        Use of QPME and noise barrier/acoustic mat

·        Regular maintenance of PMEs

·        Implementation of wastewater and drainage management

·        Retain and protect all existing trees and vegetation within the study area which are not directly affected by the works

Contract No. NL/2020/03 - Tung Chung New Town Extension – Major Infrastructure Works in Tung Chung East (Contract 3)

Land-based Works





·        UU detection works

·        Hoarding erection

·        Site haul road construction

·        Preparation works for sheetpiling

·        Site access construction at Portion 7

·        Dust emission

·        Handling and storage of C&D materials generated from construction activities

·        Noise from plant operation

·        Emission of dark smoke from PMEs

·        Efficiency of wastewater and drainage management

·        Tree protection

·        Good site practices

·        Regular water spraying on stockpiles, unpaved haul road and land filling area

·        Provide tarpaulin sheets coverage on stockpiles

·        Sorting and reuse of C&D materials as far as practicable

·        Use of QPME and noise barrier/acoustic mat

·        Regular maintenance of PMEs

·        Implementation of wastewater and drainage management

·        Retain and protect all existing trees and vegetation within the study area which are not directly affected by the works




Contract No. NL/2020/04 - Tung Chung New Town Extension – Siu Ho Wan Fresh Water Service Reservoir and Associated Mainlaying Works (Contract 4)



Land-based Works





·        Initial survey (land survey prior to the commencement of construction works)

·        Tree survey

·        Site clearance

·        Haul road formation

·        Ground investigation

·        Water pipe installation

·        Hoarding erection

·        Dust emission

·        Handling and storage of C&D materials generated from construction activities

·        Noise from plant operation

·        Emission of dark smoke from PMEs

·        Efficiency of wastewater and drainage management

·        Tree protection

·        Good site practices

·        Regular water spraying on stockpiles, unpaved haul road and land filling area

·        Provide tarpaulin sheets coverage on stockpiles

·        Sorting and reuse of C&D materials as far as practicable

·        Use of QPME and noise barrier/acoustic mat

·        Regular maintenance of PMEs

·        Implementation of wastewater and drainage management

·        Retain and protect all existing trees and vegetation within the study area which are not directly affected by the works



The ET will keep track on the construction works to confirm compliance of environmental requirements and the proper implementation of all necessary mitigation measures.  The ET will also recommend to the Contractors about the environmental toolbox topics on the abovementioned key issues for the next reporting period.

3.2                               Monitoring Schedule for the Coming Month

The tentative schedules for environmental monitoring in October 2021 are provided in Annex J.

4                 Conclusion and Recommendation

This EM&A Report presents the findings of the EM&A activities undertaken for the TCE Project during the period from 1 to 30 September 2021 in accordance with the Updated EM&A Manual and the requirements of the Environmental Permit (EP-519/2016).

Air quality (1-hour TSP), noise, water quality (DO, turbidity and SS) and soft shore ecological monitoring were carried out in the reporting period.

The monitoring results for air quality monitoring (1-hour TSP) and construction noise monitoring complied with the Action/ Limit levels in the reporting period.

No Project-related Action/ Limit level exceedances were recorded for water quality after investigation.

Based on the monitoring results for soft shore ecological monitoring, there was no evidence showing any significant difference in intertidal communities when compared against the data obtained during baseline monitoring.  The ET will continue to observe the change in density or the distribution pattern of horseshoe crab, seagrass and intertidal soft shore communities taking into account natural fluctuation in respect of the occurrence and distribution pattern.

Environmental site inspections were carried out during the reporting period.  Recommendations on remedial actions were given to the Contractors for the deficiencies identified during the site inspections.

There was no notification of summons or prosecution recorded in the reporting period.  One (1) environmental complaint related to Contract 3 was received in the reporting period.  Investigation was conducted for the environmental complaint in accordance with the complaint handling process as stated in the Complaint Management Plan.

The ET will keep track on the construction works to confirm compliance of environmental requirements and the proper implementation of all necessary mitigation measures.







([1])       ERM (2018a).  Updated Environmental Monitoring and Audit Manual for Tung Chung New Town Extension. Deposited to EPD under EP-519/2016

([2])       Arup (2015).  Environmental Impact Assessment Report for Tung Chung New Town Extension. Deposited to EPD under Register No. AEIAR-196/2016

([3])       Impact monitoring at monitoring station NMS-CA-1A commenced on 19 September 2018 in view of the close vicinity of the construction works near the residential area at Century Link.

([4])       Due to land handover issue, NMS-CA-1A was relocated to Ying Hong Road which is located 60m away from the original location.  Proposal on the relocation of NMS-CA-1A was approved by IEC on 23 November 2018.  Noise monitoring at the relocated location commenced since 24 November 2018.

([5])       ERM (2018b).  Baseline Monitoring Report for Tung Chung New Town Extension (East). Submitted to EPD under EP-519/2016
